How to Prepare a New-Home Building-Envelope Materials Compatibility Register Before Ordering

Use a layer-and-interface worksheet to verify envelope materials, accessories, sequence, responsibility, evidence, warranties and open approvals before ordering.

By Brictale · Published · Updated · Research and review method

The short answer

Before ordering, make one register row for every envelope layer and interface—not just each product. Record the exact revision, substrate, adjacent materials, compatible accessory, sequence, exposure limit, code or evaluation evidence, responsible person, inspection record, warranty condition and unresolved question. Release only rows that are documented, assigned and verified; route structural, fire, vapor-control, hygrothermal and local-code questions to the architect, engineer, builder or building official.

How to Prepare a New-Home Building-Envelope Materials Compatibility Register Before Ordering

Before ordering, make one register row for every envelope layer and interface—not just each product. Record the exact revision, substrate, adjacent materials, compatible accessory, sequence, exposure limit, code or evaluation evidence, responsible person, inspection record, warranty condition and unresolved question. Release only rows that are documented, assigned and verified; route structural, fire, vapor-control, hygrothermal and local-code questions to the architect, engineer, builder or building official.

1. Set the release rule before anyone orders #

Do not release a new-home envelope package until every material and critical interface has a named decision owner, a traceable source, an installation sequence and a verification record; a familiar brand name or a visually plausible wall section is not enough.

This guide is for a United States single-family home at pre-order or pre-installation stage. “United States” is not a building jurisdiction. The applicable requirements are those adopted and enforced for the project by the responsible state, county or city authority—often a building department or code official—with any amendments, permit conditions and special requirements that authority applies. The current official ICC-ES ESR-1993 report identifies the named product, evaluated properties, code editions and conditions, but it is not an endorsement and does not prove unaddressed attributes or the performance of your complete wall. Its cover is reissued August 2024 and marked “Subject to renewal August 2026.” ICC-ES’s official report directory says downloadable reports remain valid when a re-examination date has passed if they are under re-examination or covered by a legacy extension; that status note does not make the report a local approval. The project team must still confirm the locally adopted code, permit conditions and the authority’s acceptance of this product and use.

The homeowner’s job is coordination and evidence collection, not remote approval. The architect or engineer owns the design assumptions and any required structural, fire, vapor-control or hygrothermal analysis. The builder owns procurement coordination, means and methods, subcontractor scope and construction quality unless the contract allocates those duties differently. The siding, masonry, roofing, window, insulation and waterproofing trades own their work within the approved documents and must identify conflicts before covering a preceding layer. A third-party energy rater, program verifier or inspector has only the authority assigned by the program, contract or jurisdiction.

The release decision has three possible outcomes:

  • Release: the exact product and revision are identified; adjacent materials and accessories are documented; the sequence can be built; the applicable code or evaluation path is assigned; a responsible person has accepted the item; and verification evidence is defined.
  • Release with a bounded hold: materials that are unlikely to change the unresolved question may be ordered, but the affected interface, accessory, quantity or installation cannot be released. The purchase order must say what is excluded and who must approve it.
  • Do not release: a missing substrate, unknown product revision, unsupported sealant, unverified attachment, missing flashing, incompatible sequence, unassigned code question or warranty condition could change the package. Stop that package until the question is answered in writing.

The point is not to prove that every brand works with every other brand. The point is to show why the selected combination is acceptable for this project—or expose the exact question that prevents a safe order. That distinction protects the schedule: a clear “not yet” on one interface is more useful than a broad order that later forces demolition, substitution or a design change. For the broader material-method decision around this register, continue with materials planning and systems after the open interface has an owner.

For a homeowner, the register is most useful when it changes a conversation into a traceable decision. Before approving a purchase, ask the builder to point from the purchase-order line to the corresponding register row, drawing detail and verification record. If the row depends on a pending window dimension, attachment calculation, manufacturer response or local interpretation, mark that dependency instead of hiding it in an email thread. A bounded hold can keep unrelated procurement moving, but it must name the excluded material and the event that releases it. This makes the next handoff visible: the person answering the question knows what evidence is needed and the homeowner knows what remains undecided.

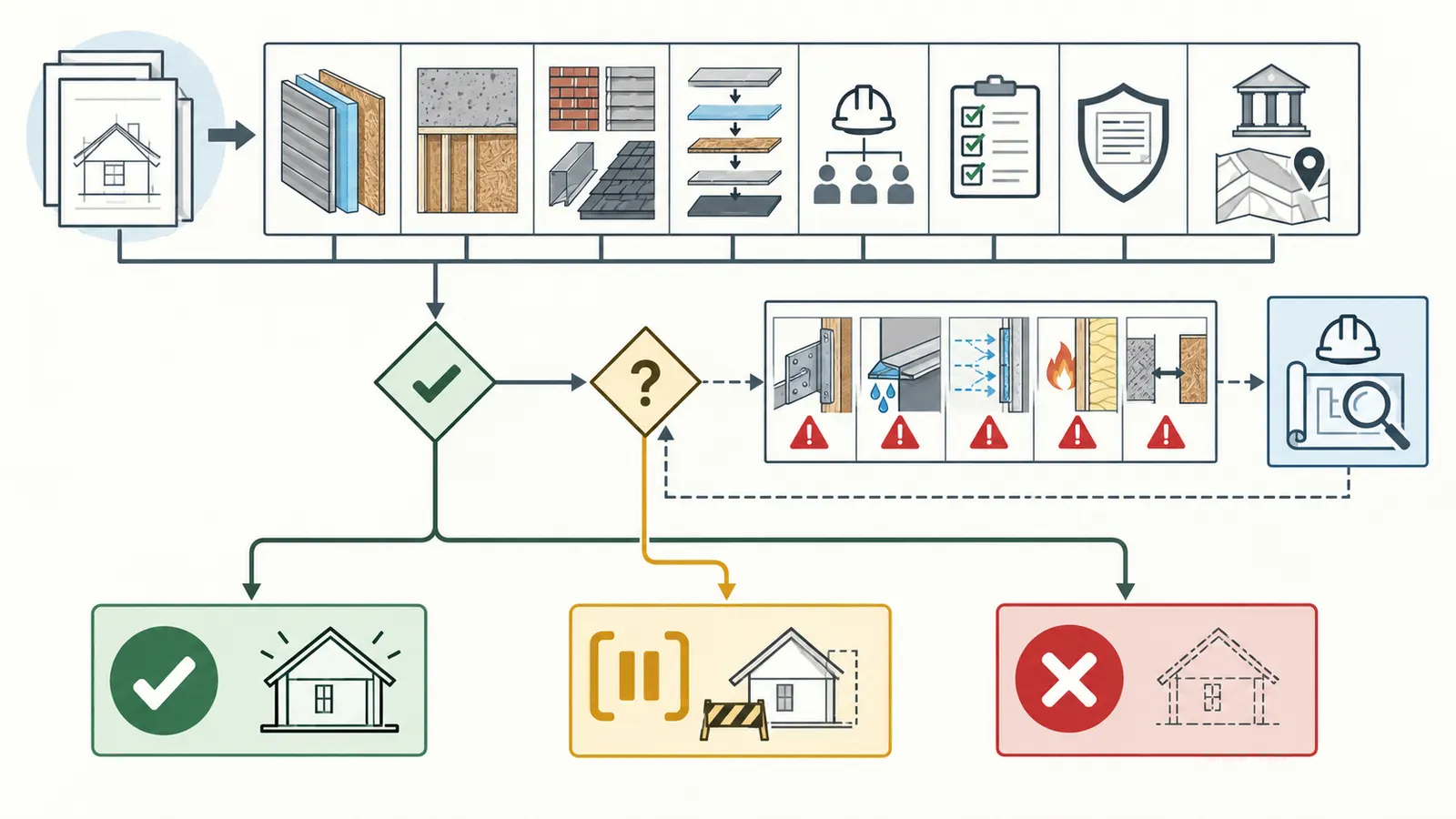

Decision map showing release, bounded hold, and do-not-release paths for an envelope purchase package.

The compact originality brief

Current answers are fragmented across DOE and EPA enclosure guidance, code-evaluation reports, and individual manufacturer manuals, warranties and compatibility FAQs. The missing decision is whether the selected materials can be released as one coordinated package before purchase. The original contribution is the Envelope compatibility register and pre-order release gate: a source-comparison worksheet with a row for every layer and interface, followed by an illustrative two-wall-package review and a sensitivity showing how exterior insulation thickness and cladding weight change attachment and review needs.

You can check the contribution by asking another person to recreate the same result from the same product revisions. They should be able to identify every material, see which source supports each statement, find each unresolved owner and reproduce the example’s calculations. If they cannot, the register is incomplete. This is a modeled editorial tool, not collected field data, laboratory testing, a code document or professional design approval.

What this register does not decide

It does not remotely select a wall assembly, size framing, calculate wind or seismic loads, approve a masonry veneer, select a fire-resistance-rated assembly, determine condensation risk, decide a vapor-retarder class, approve a window installation, or replace a permit review. Those decisions depend on the project’s drawings, climate, exposure, geometry, materials, code edition, engineering and local authority.

It also does not turn a manufacturer’s word “compatible” into a whole-system warranty. A product page may describe one item’s properties. A warranty may cover a named product or a named set of accessories. An evaluation report may cover a product under listed conditions. None by itself covers every adjacent product, fastener, substrate, exposure duration and installer decision. The register keeps those claims separate.

2. Freeze the inputs that make compatibility meaningful #

Compatibility cannot be reviewed until the project team freezes the wall geometry, climate and code inputs that determine what each product must do and what can touch it.

Start a register only after the design team can issue a coordinated wall section, even if it is marked “for procurement coordination” rather than “issued for construction.” The section should identify the exterior cladding, drainage or ventilation space, water-resistive barrier, sheathing, framing, insulation, interior air or vapor control layer, interior finish, openings, base, top, corners, roof-to-wall conditions and penetrations. A list saying “fiber cement over insulation over WRB” is not enough. It omits the support plane, fastener path, drainage path, flashing, transitions and responsibility. If those inputs are still being chosen, return the handoff to the home design and layout brief before treating the register as a purchasing record.

Record these inputs on the first page of the register:

InputWhat to recordWhy it changes the decisionOwner to confirm
Project jurisdictionState; county if relevant; city or town; building department; adopted code edition and amendments; permit statusA model code, program checklist or ESR is not automatically the local ruleHomeowner with architect or builder; building official for interpretation
Climate and exposureIECC climate zone if used by the design; moisture zone; wind-driven-rain exposure; wind, wildfire, snow or marine concerns where applicableVapor control, drying, fire provisions, flashing and exposure limits are not universalArchitect or engineer
Wall geometryFraming spacing; sheathing; wall height; corners; offsets; parapets; roof and foundation transitionsDetermines lap, fastening lines, movement and continuityArchitect or engineer
OpeningsWindow and door type, flange or non-flange condition, sill, head, jamb, rough-opening size and sequenceOpening flashing is an interface, not an accessory afterthoughtWindow supplier and builder, reviewed by design lead
CladdingProduct family, profile, weight per area, joint pattern, attachment method, finish and clearancesChanges furring, fastener, joint-flashing and substrate needsArchitect, cladding trade and builder
Exterior insulationExact product; thickness; facer; board dimensions; compressive or attachment guidance; number of layersChanges cladding support depth, screw length, thermal and drainage geometryArchitect or engineer with insulation and cladding trades
Interior control layersAir barrier, vapor retarder or smart membrane, location, penetrations and service cavityAir leakage and vapor diffusion are different control problemsArchitect or enclosure consultant
Procurement stateApproved product, acceptable alternate, lead time, storage location, lot or revision recordA substitution can change warranty, accessory and sequenceBuilder and homeowner

The DOE distinction between air barriers and vapor retarders is a useful guardrail. An air barrier limits air-transported moisture; a vapor retarder reduces vapor diffusion. Whether, where and how a vapor retarder is used depends on climate and construction. Therefore, do not put “vapor barrier” in a purchasing list as if it were interchangeable with “housewrap,” and do not infer the needed interior layer from a product’s water-resistance label. The design professional must resolve the assembly’s control-layer strategy.

Record the physical facts, not marketing categories

For each selected item, record the exact product name, model or grade, dimensions, thickness, facer or coating, package unit, manufacturer document title, document revision or publication date, access date, and any identified lot or batch information. A product family can include several housewraps, tapes, sealants or flashings with different conditions. “Brand X tape” is not a traceable item.

For each adjacent pair, record the actual contact or separation. “Insulation next to WRB” may mean direct contact, a drainage mat between them, a taped insulation face, or a cladding attachment cavity. “Cladding over insulation” may mean screws through furring into studs, clips into structure, masonry ties, a proprietary rail or an assembly not yet designed. Each is a different interface.

Use units consistently. Record insulation in inches or millimeters, cladding weight in pounds per square foot, furring in inches, fastener diameter and embedment in the units used by the source, and exposure time in days. Do not convert a manufacturer’s threshold silently. If the drawing uses millimeters and a manual uses inches, show both and retain the original value in a notes field.

Separate five kinds of evidence

Every row should label the evidence type. This prevents a common category error in which a product test result is treated as a code approval or a warranty term is treated as an installation instruction.

  1. Physical fit: the layers can occupy the available space without crushing, buckling, blocking drainage or misaligning the opening.
  2. Documented compatibility: the manufacturer’s instruction, technical bulletin, detail or FAQ specifically permits the contact, accessory or sequence under stated conditions.
  3. Code or evaluation evidence: the local authority’s adopted provisions, an approved alternate path, or an evaluation report covers the named product and use. The current official ICC-ES ESR-1993 report illustrates the limit: its scope applies to the named DuPont Tyvek ThermaWrap LE product and listed conditions, not to every WRB or every wall. Its cover still shows “Subject to renewal August 2026,” while the ICC-ES report-directory status note says downloadable reports remain valid when a re-examination date has passed if they are under re-examination or covered by a legacy extension. Treat that as report-directory status, not as a blanket local approval; the project team must confirm the applicable authority and use.
  4. Verification evidence: a photograph, delivery record, marked-up drawing, inspection checklist, fastener log, product label or signed trade confirmation that shows the work or material matches the decision.
  5. Warranty evidence: the actual warranty document, term, covered property, listed accessory set, exclusions and required installation conditions.

Mark any conclusion supported only by the first category as open. A board that fits between two layers may still be unsupported, have the wrong perm or facer, require a different fastener, violate an opening detail or fall outside the warranty.

3. Build the layer-and-interface worksheet #

The usable worksheet has one row for each layer and one additional row for each place where a layer changes, stops, is penetrated or meets another material.

Copy this structure into a spreadsheet or project-control document. The “status” is deliberately strict: green means documented and assigned, amber means bounded but not releasable at the affected interface, and red means an unresolved condition can change the order or installation.

ID / layer or interfaceExact product and revisionSubstrate and adjacent materialsCode / ESR / manufacturer evidenceCompatible accessory and sequenceExposure or use limitResponsible personVerification recordWarranty conditionUnresolved risk / next handoffStatus
L1 structural frame and sheathingSpecies or framing system; sheathing panel and thickness; drawing revisionStuds, headers, OSB or plywood, openingsStructural drawings and locally adopted requirements; APA moisture guidanceFrame, sheath, dry-in, inspect before WRBJobsite wetting and storage limits from supplierArchitect or engineer; builderFraming and sheathing inspection, panel labels, photosPanel maker’s exposure and installation conditionsConfirm moisture condition and hold points with builderAmber until inspected
L2 WRB fieldExact WRB, roll width, document revisionSheathing or approved insulation face; cladding sideProduct manual; DOE drainage-plane guidanceApproved tape or sealant; install shingle-style and integrate with flashingProduct’s stated uncovered time, UV and substrate limitsWRB trade, builderRoll labels, seam and lap photos before claddingProduct-only or system warranty, exact accessoriesConfirm product is the specified family, not a substituteAmber until documents match
L3 WRB seams and cornersSame WRB plus named tape or sealantWRB to WRB, corners and transitionsManual and chemical-compatibility bulletinTape, primer or sealant named by manufacturer; clean and dry substrateTemperature, dust, moisture and cure limitsWRB tradeLot numbers, temperature/weather note, close-up photosListed accessory and installation methodAsk manufacturer if mixed-brand sealant is proposedRed if unnamed
L4 base, top and roof-to-wallFlashing type and membrane revisionWRB, foundation, roof underlayment, claddingEPA water-managed wall checks; details and local codeLower layer receives upper layer; provide outward drainage; sequence before claddingExposure and compatible substrate from each productBuilder and waterproofing or roofing tradeDetail photo before cover; marked-up sectionWarranty may require specified flashingDesign lead resolves laps and transitionsRed if no detail
L5 windows and doorsManufacturer, model, flange condition and installation guideRough opening, sill, jamb, head, WRB and flashingWindow manual, WRB manual and local approved detailSill pan or membrane, jamb/head flashing, backdam or sealant as specifiedOpening size, temperature and temporary exposure limitsWindow installer; builder coordinates WRB tradeSill/head/jamb photos and product labelsWindow and WRB warranty conditionsWindow supplier and architect approve interfaceRed until sequence is issued
L6 penetrationsEach vent, pipe, light, hose bib, electrical box and bracketPenetration, WRB, flashing and claddingProduct detail and local electrical/plumbing/mechanical requirementsBoots, collars, sealant or flashing; install before or after WRB as detailedMovement, temperature, UV and service accessRelevant trade; builder coordinatesPenetration map and photosSealant/accessory conditionsAssign every penetration to one tradeAmber if mapped
L7 exterior continuous insulationExact board, thickness, facer and revisionSheathing or WRB; furring or clips; claddingInsulation guide; energy and fire design; ROCKWOOL attachment guidanceMechanical attachment, washers, furring, long screws or engineered clipsBoard support, moisture and temporary exposure limitsArchitect or engineer; insulation and cladding tradesBoard labels, layout, fastener log and photosWarranty and tested assembly conditionsRecheck when thickness or cladding weight changesRed if support path absent
L8 furring / cladding supportSize, species or gauge; spacing; rail or clip modelInsulation, sheathing, studs, claddingStructural attachment design and product guideScrews penetrate designed framing; maintain drainage cavityWind, gravity, corrosion, edge distance and movementEngineer or architect; builderLayout, screw type and embedment recordCladding system conditionsEngineer resolves load path and corrosion classRed until designed
L9 cladding fieldExact cladding, profile, finish and installation revisionFurring or structural backup, WRB and joint flashingCladding manual; local code; Hardie lap-siding guidance where applicableStarter, joints, trim, flashing and fasteners in sequenceClearance, joint, finish and weather limitsCladding tradeCourse, joint and flashing photosCladding warranty’s substrate and installation termsConfirm local flashing dimension and substrateAmber until mock-up
L10 masonry or stucco transitionVeneer/stucco system and accessoriesWRB, bond-break drainage plane, lath, shelf angle, weepsEPA wall checklist, engineered/detail packageBond break, flashing, weeps or screed in sequenceMortar, curing, drainage and corrosion conditionsMasonry/stucco trade; architectPre-cover photo and inspection recordAssembly and manufacturer conditionsDesign lead resolves non-structural vs structural masonryRed if bond break absent
L11 interior air / vapor controlExact membrane, coating or gypsum strategyInterior finish, framing, insulation and penetrationsClimate-specific design and adopted code; DOE air/vapor guidanceSealants, tapes, gaskets and service cavity; sequence before closingClimate, drying direction and penetrationsArchitect or enclosure professional; builderAir-seal checklist and photos before drywallProduct and assembly conditionsProfessional resolves condensation riskRed if merely labeled “vapor barrier”
L12 cladding-to-roof and base handoffMetal, membrane, drip edge, kickout or termination productsRoof, wall WRB, siding, gutters, foundationRoof and wall details; EPA flashing checksInstall drainage from upper to lower layer; coordinate gutter dischargeRain, snow, sealant and corrosion limitsRoofing and siding trades; builderHandoff photo and checklist sign-offEach product’s termination conditionsBuilder schedules joint inspectionRed if trades install independently
L13 storage and protectionAll products and packagingGround, weather, sunlight and site trafficEach product’s storage and handling instructionsStore flat or supported; protect from water and contaminationExposure limit starts at delivery if product says soBuilder or site superintendentDelivery photos, dates and damaged-material logWarranty may exclude damaged or misused materialQuarantine damaged or wet stockAmber until logged

The row is not complete when a URL is pasted into it. Add the exact claim from the document, the page or section, the date checked and the condition that makes the claim applicable. If a PDF changed between design and ordering, preserve the reviewed copy in the project record and recheck the current revision. Do not overwrite the earlier decision without recording the change.

Annotated wall cutaway paired with a register row for layers, interfaces, accessories, owners, and verification records.

The interface inventory that people forget

Walk the wall section with a highlighter and mark every interruption. Typical omissions include the bottom of wall, window sill and head, door threshold, roof-to-wall step, parapet, deck ledger, porch roof, outside and inside corners, change from siding to masonry, utility penetrations, hose bibs, exterior outlets, light fixtures, exhaust terminations, dryer vents, refrigerant lines, satellite brackets, railings, gutters and cladding butt joints.

The DOE drainage-plane guidance says the WRB should be continuous behind cladding, with seams sealed, and should lap over flashing around openings, penetrations, the wall top and base. That is a coordination rule for the register, not a universal detail dimension. The practical translation is: if you cannot draw the water path from the highest exposed joint to the exterior without crossing an unassigned trade’s work, the row is not green.

For non-structural masonry, stucco or another cladding that can hold water against the wall, add a separate bond-break or drainage-plane row rather than hiding it in “WRB.” EPA’s Indoor airPLUS Version 2 checklist lists a continuous WRB behind cladding, a bond-break drainage plane for non-structural masonry, flashing or drainage at horizontal interruptions and wall bottoms, weeps for masonry or a weep screed for stucco, and fully flashed windows and doors. Indoor airPLUS is a voluntary program, not automatically the project’s code, but its checklist is a useful completeness test.

4. Review each compatibility question in the right order #

Review the register from structure to weather exposure, then from water control to air and vapor control; do not approve a top layer while the support and drainage path beneath it remain uncertain.

Use this review order for every row and interface:

  1. Can it be built in the stated geometry? Check thickness, gaps, offsets, opening sizes, furring depth, fastener length and access. Measure from the coordinated section rather than from a product photograph.
  2. Can the substrate accept it? A tape, membrane, flashing or fastener may require clean sheathing, a particular facer, dry concrete, wood framing or a specified backing. Record “substrate not confirmed” as an open issue.
  3. Is the contact documented? Find a manual detail, technical bulletin, compatibility table, warranty condition or written manufacturer response for the proposed adjacent material. If the document says “compatible with standard sealants,” identify whether that means a class of products, a named list or a surface condition.
  4. Does the assembly drain and dry? Trace rainwater, incidental water, construction moisture and vapor movement. The APA moisture guidance identifies missing or improper flashing, WRB installation, wall intersections and penetrations as important contributors to wall water damage, and says WRB lapping, sealing and integration with flashing are critical. It also notes that rain-screen construction can add protection in wind-driven-rain areas; that does not by itself determine cavity depth or screen design.
  5. Can the next trade install its layer without destroying the previous one? A screw through a membrane, a masonry tie through a flashing, a window fin installed after the WRB or a furring strip blocking drainage is a sequence issue. Write the order in verbs: sheath, inspect, flash sill, install window, integrate WRB, flash head, install insulation, install furring, inspect cavity, install cladding.
  6. Does the evidence cover this exact product and use? A report for Tyvek ThermaWrap LE does not automatically cover Weathermate Plus. A product page for a Hardie weather barrier does not automatically approve a mixed-brand flashing. A board insulation guide’s baseline fasteners do not replace the attachment design for heavy cladding.
  7. Who can accept the decision? Assign the homeowner for scope and budget choices, the builder for coordination and procurement, the design professional for design and performance, the relevant trade for installation feasibility, the manufacturer for a product-specific response, and the building official for jurisdictional interpretation or approval when required.
  8. What record proves completion? Choose the record before work is covered: photo with a location reference, marked-up detail, product label, delivery docket, fastener log, moisture reading by a qualified person, inspection report or signed trade checklist.

Read manuals for conditions, not slogans

Start at the “scope,” “limitations,” “substrate,” “installation,” “facade considerations,” “chemical compatibility,” “storage,” “exposure,” “warranty” and “technical support” sections. Search the document for the exact adjacent material and the words “not,” “only,” “approved,” “minimum,” “maximum,” “must,” “shall,” “except,” “compatible,” “cover,” “exposure” and “penetrate.” Capture the surrounding condition, not just the favorable sentence.

DuPont’s March 12, 2025 typical wall drawing is a good example of conditional evidence. It shows a residential wood-frame assembly with Tyvek WRB over Styrofoam XPS, OSB, studs with batt insulation, an interior vapor retarder where required and gypsum board. It calls for taped WRB joints, shows vertical seam overlap of 6–12 inches and a minimum 6-inch horizontal lap, and says the applicable installation guideline should determine the WRB for the cladding type. It also directs vapor-retarder use to applicable building codes and sealant questions to chemical-compatibility guidance. Treat these as inputs to a review, not as permission to copy the drawing into a different wall.

The manufacturer’s wording may deliberately stop short of whole-wall approval. James Hardie says in its weather-barrier product information that no exterior cladding prevents 100% of water intrusion and describes a suite of separate housewrap, Pro-Flashing, Flex Flashing and Seam Tape products. Its page also says availability may be limited by location. A package using a James Hardie cladding with another company’s WRB therefore needs a project-specific interface review, even if both products are individually reputable.

Benjamin Obdyke’s HydroCorner FAQ says that product is compatible with most caulks, sealants and straight-flashing tapes and that a mechanical fastener is sufficient to hold it before sill flashing. The words “most” and “before sill flashing” matter. They do not mean every sealant, every tape or every sequence is approved. Put the proposed sealant and tape names in the row and ask for a written response if the combination is outside the named guidance.

Verify the control-layer logic separately

A wall can be rain-tight at the surface and still have an unresolved air or vapor strategy. The DOE guidance says a vapor retarder’s location and need depend on climate and construction, and recommends continuity and sealing to limit moist air entering a cavity. This is why the register needs separate rows for exterior water control, air control and vapor control, even where one product may perform more than one function.

The homeowner can ask the design professional to identify, in a section, the intended control layers and their transitions. Ask: Which layer is the water-resistive barrier? Which layer is the primary air barrier? Where is the vapor retarder, if any? How does each cross a window, roof, foundation, corner and penetration? Which layer must remain continuous after furring and services? What drying direction was assumed? What change would require hygrothermal review?

Do not answer those questions by comparing perm numbers alone. DuPont lists a 5 perm minimum water-vapor transmission rating for Weathermate Plus Housewrap, but that product fact does not determine the whole wall’s vapor profile. A product’s permeability, the sheathing, insulation ratio, interior finish, climate and air leakage all interact. Record the number as a product input and let the design professional decide how it is used.

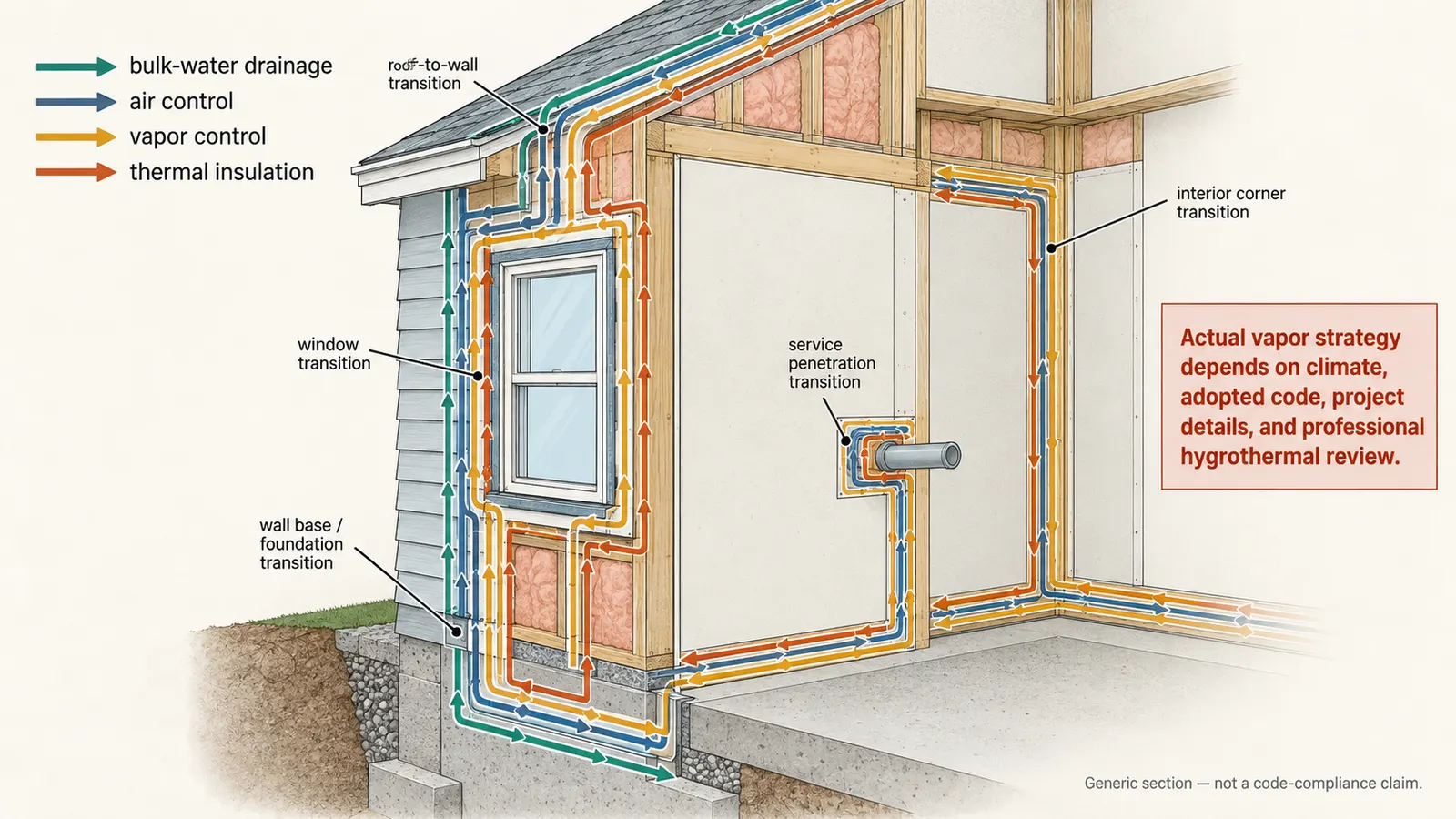

Wall-section diagram tracing water, air, vapor, and thermal control layers through an opening and roof-to-wall transition.

5. Coordinate attachment, weight and the construction sequence #

Treat exterior insulation and cladding support as a load-path and sequencing decision; increasing insulation thickness or cladding weight can change fastener length, spacing, furring, engineering review and the number of trades involved.

This is the interface most likely to be falsely marked “compatible” because the boards physically fit. A cladding system has gravity, wind, movement, corrosion and edge-distance demands. The support may need to transfer loads through insulation and sheathing into studs, blocking, masonry or an engineered clip. The WRB, flashing and drainage cavity must remain functional while that support is installed.

ROCKWOOL’s Comfortboard 80 residential guide recommends permanent mechanical attachment and mechanical fasteners with minimum 2-inch-diameter washers. It recommends at least five attachments per board when only mechanical fasteners or impaling pins support the board, but it also says requirements may vary when the boards are installed within a cladding attachment system. Put both statements in the register. The five-attachment baseline is not a substitute for the cladding attachment design.

ROCKWOOL’s official Board Insulation Attachment Guide organizes attachment around exterior insulation thickness, cladding weight, stud spacing, fastener diameter, embedment and strapping. It specifically states that long screws must penetrate framing members and that project-specific cladding loads affect specification. This gives the homeowner a practical change-control trigger: a change in board thickness, cladding mass or stud spacing reopens the attachment row.

Worked example: two illustrative wall packages

The following is an illustrative modeled example, not a recommendation, tested result, estimate of code compliance or professional design. Its purpose is to show how the register changes when one input changes. Assume a hypothetical two-story wood-framed home in the United States with 16-inch-on-center studs, OSB sheathing, a continuous exterior insulation layer, vertical furring over studs and a lap cladding. No wind pressure, seismic demand, fire rating, opening geometry, fastener withdrawal value, structural capacity or local amendment is supplied; therefore the attachment remains a professional review item.

Package A inputs

  • Exterior insulation: 2 inches thick.
  • Cladding: illustrative light-to-medium lap cladding, modeled at 4 pounds per square foot.
  • Furring: a proposed 3/4-inch-deep vertical strip, subject to design confirmation.
  • Sheathing: OSB, exact thickness not assumed.
  • Fastener: proposed long screw, exact diameter and embedment not selected.
  • WRB: an exact product must be selected; a brand family is not enough.

Package B inputs

  • Exterior insulation: 5 inches thick.
  • Cladding: illustrative medium-to-heavy cladding, modeled at 9 pounds per square foot.
  • Furring: a proposed 3/4-inch-deep vertical strip, subject to design confirmation.
  • All other assumptions remain the same.

The simplified geometric relationship for a first coordination check is:

minimum screw length for the proposed stack = insulation thickness + furring thickness + sheathing and finish allowance + required structural embedment + washer or head allowance

This formula only checks whether the screw can span the stack and reach the intended framing. It does not prove capacity, spacing, pull-through resistance, corrosion suitability, edge distance or code compliance. Let the unknown design allowance be A and required structural embedment be E.

For Package A, the known exterior stack before the unknown allowances is:

2.0 in insulation + 0.75 in furring = 2.75 in

So the coordination length is:

L_A = 2.75 in + A + E

For Package B:

5.0 in insulation + 0.75 in furring = 5.75 in

L_B = 5.75 in + A + E

The modeled thickness change alone is:

L_B - L_A = 5.75 in - 2.75 in = 3.0 in

The result is not “buy a screw three inches longer.” It is “reopen the attachment design because the fastener must cross three additional inches before reaching the same structural target, while the cladding load and the insulation support condition also changed.” The architect or engineer and the attachment or cladding manufacturer must select the actual system.

The register should show the sensitivity like this:

Modeled input changeDirect coordination effectDecision that reopensWhat cannot be inferred
Insulation from 2 to 5 inchesExterior stack grows 3 inches; screw path, furring alignment and opening returns changeFastener length, embedment, strapping and window/door extension detailsCapacity, wind resistance or code approval
Cladding from 4 to 9 lb/ft²Gravity and wind-support demand may increase; joint and trim support may changeAttachment schedule, furring size, fastener diameter, backing and engineer reviewThat any particular screw or spacing is adequate
Same WRB but a different claddingFacade guidance, exposure and accessory compatibility may changeWRB selection, seam treatment, flashing and warranty reviewThat a cladding-neutral drawing covers the new facade
Same cladding but mixed-brand flashingProduct contact and warranty evidence changesNamed compatibility response and warranty conditionThat “standard sealant” means every product
Same layers but a window changes from flanged to non-flangedOpening geometry and sequencing changeSill, jamb, head and WRB integration detailThat the old window flashing detail transfers

Use sensitivity to control substitutions. If a supplier says the 5-inch board is unavailable and proposes 3 inches, that is not necessarily a harmless saving. It may change energy calculations, window returns, screw lengths, furring, thermal bridges, cladding alignment and the interior or exterior moisture strategy. If the owner selects a heavier brick veneer instead of lap siding, the support path and drainage details may change. The next handoff is design review, not a purchasing preference.

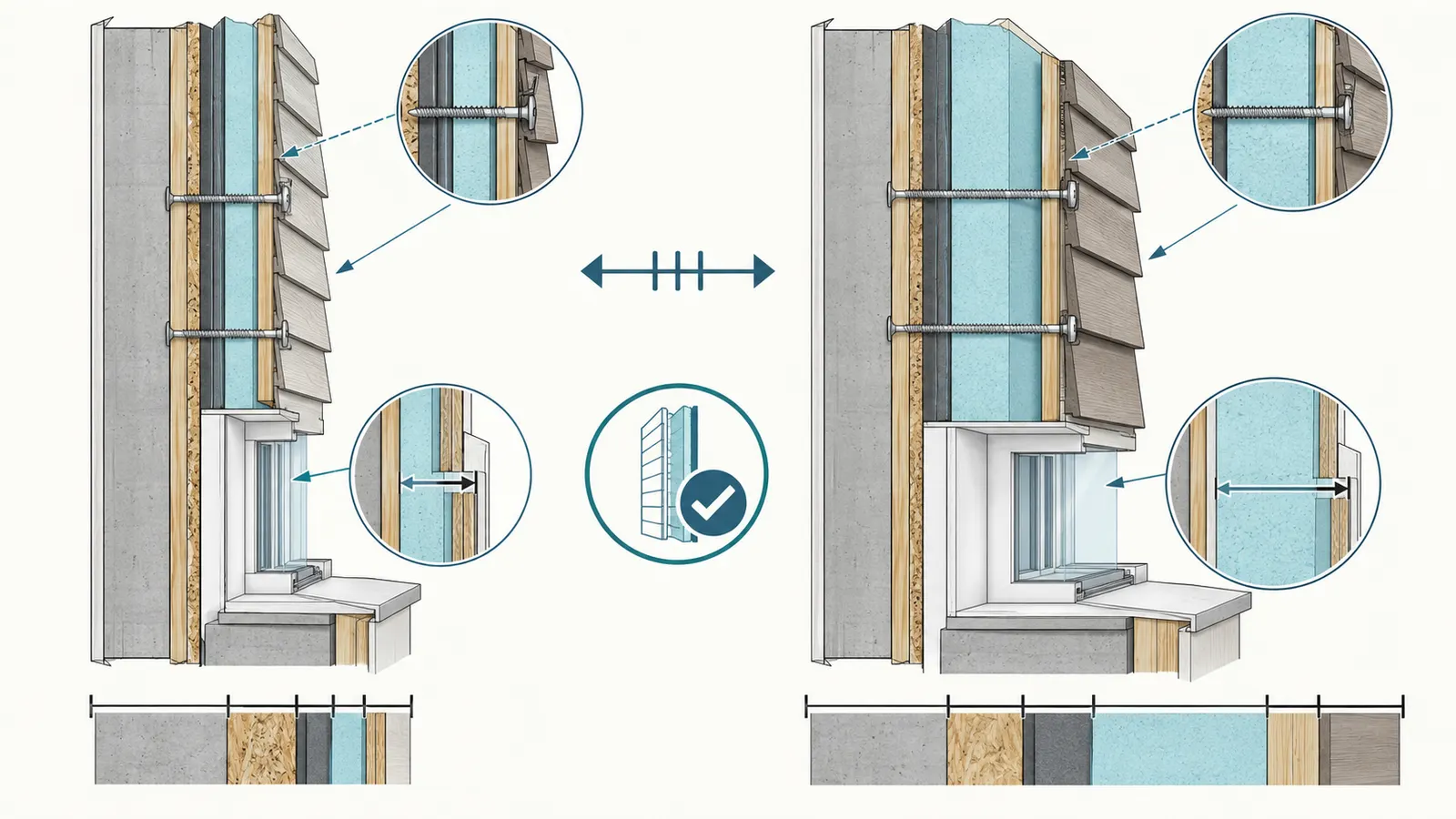

Comparison graphic showing how thicker insulation and heavier cladding reopen fastener, furring, load-path, and opening decisions.

Sequence the handoffs on a real wall

Write the construction sequence with a responsible person beside each verb. One possible coordination sequence, to be replaced by the approved project detail, is:

  1. The framing trade builds the wall and openings to the issued drawings.
  2. The sheathing trade installs and records the panel product, fastener pattern and any damaged or wet panels.
  3. The builder or design lead inspects the substrate and confirms that the specified WRB can be installed on it.
  4. The window supplier and installer confirm rough openings and the sill, jamb and head sequence before the WRB is covered.
  5. The waterproofing or window trade installs the sill flashing or pan, window and opening flashings as detailed.
  6. The WRB trade installs the field membrane, tapes or seals seams, and integrates it with opening and transition flashings.
  7. The builder records penetrations and confirms which trade owns each boot, collar, seal or patch.
  8. The insulation trade installs the exact board with the approved attachment method, preserving drainage and opening transitions.
  9. The engineer, architect or delegated inspector verifies the furring and attachment layout before cladding covers it.
  10. The cladding trade installs starter, joints, trim, flashing and field pieces according to the issued detail and product guide.
  11. The builder and design lead inspect bases, corners, openings, penetrations, roof-to-wall transitions and cladding joints before closeout.

The sequence may differ, especially with exterior insulation over a WRB, a self-adhered WRB, a non-flanged window or masonry veneer. The rule is not that one sequence is universal; the rule is that the team must choose a sequence and identify the handoff where one trade’s work becomes another trade’s substrate. Carry that approved sequence, inspection point and unresolved-risk owner into construction decision and inspection planning before the first covering trade starts.

6. Verify exposure, accessories, warranties and substitutions #

Order only the product-and-accessory combination whose exposure, storage, installation and warranty conditions are recorded for the actual project; a product’s standalone specification is not a system warranty.

Track temporary exposure from delivery, not memory

Temporary exposure is a schedule input. DuPont says Weathermate Plus Housewrap may remain uncovered for up to 120 days and lists product properties including a 5 perm minimum vapor-transmission rating. The same page says to review instructions and the safety data sheet and to contact a local DuPont Tyvek specialist before writing specifications. Record “up to 120 days” only in a row naming that exact product and revision. Do not copy it to another housewrap, to a taped XPS face or to an assembly with unprotected seams.

Ask the builder to record the date each exposure-sensitive layer is installed, the date it is covered, weather events, damaged areas and repair material. The safest interpretation of a manufacturer’s maximum is a limit, not a production target. If the cladding schedule may exceed the limit, ask the manufacturer and design lead for a written plan before ordering; do not assume extra tape or paint extends the period.

Storage deserves its own row because damage can happen before installation. For each product, record whether it must be kept dry, elevated, supported, wrapped, shaded or protected from traffic. Photograph deliveries before unloading if the contract makes the builder responsible for damage. Quarantine torn, crushed, wet or contaminated rolls and boards until the responsible supplier or design lead decides whether they may be used. The homeowner can document the condition; a qualified person should decide whether damaged material remains fit for the assembly.

Read a warranty as a boundary map

The DuPont U.S. residential warranty overview distinguishes a 10-year product-only water warranty for Weathermate Plus Housewrap with Weathermate accessory products from listed Tyvek wrap systems paired with specified DuPont self-adhered flashing and, for some systems, DuPont continuous insulation. The table also distinguishes product and labor coverage and water, air, thermal or drainage coverage. That is precisely why the register needs a warranty column.

For every warranty claim, record:

  • named product and accessory set;
  • covered property, such as water, air, thermal or drainage;
  • term and start date;
  • required installer or installation method;
  • substrate and cladding assumptions;
  • exclusions for damage, exposure, incompatible materials or alterations;
  • documents the owner must retain; and
  • the person who will request written clarification.

Do not say “the wall is under warranty” when the document covers only a product or named product combination. Do not say “mixed-brand accessories are fine” because one FAQ says “most” sealants are compatible. If the package departs from the named set, mark the warranty as not established until the manufacturer gives a written answer or the owner accepts the risk after professional review.

Make substitutions follow the same gate

The builder should not substitute an “equivalent” envelope product by brand category. A substitution request should show the original row beside the proposed row and compare:

ComparisonOriginalProposedRelease question
Product identityExact model, thickness, facer and revisionExact model, thickness, facer and revisionIs the proposed product covered by the same detail or report?
Control functionWater, air, vapor or thermal roleClaimed roleDoes the wall’s control-layer strategy remain continuous?
Adjacent materialsWRB, tape, flashing, insulation and claddingNew adjacent setIs contact documented for each interface?
DimensionsLaps, thickness, returns and cavityNew dimensionsDo windows, doors, furring and trims still fit?
AttachmentFastener, spacing, embedment and backingNew methodHas the load path been reviewed?
ExposureTemporary cover, UV and storageNew limitDoes the construction schedule still work?
WarrantyNamed product system and coverageNew coverageIs the warranty preserved, narrowed or unknown?
ApprovalCode, ESR or local acceptance pathProposed pathWho must approve before purchase?

A substitution is not complete when the builder initials it. The relevant design professional must accept design effects; the applicable trade must accept installation effects; and the homeowner should receive the change, price, schedule and warranty consequences. If the substitution changes a code, fire, structural or moisture-control assumption, route it through the project’s formal change process and local authority where required.

7. Diagnose common failure branches before they become orders #

When a register row fails, classify the failure by its missing decision, freeze the affected release, assign the right owner and carry the question to the next handoff with evidence attached.

Failure branch: the package names products but not revisions

Observe: “Housewrap,” “flashing tape,” “rigid mineral wool” or “Hardie siding” appears in the quote, but no model, thickness, facer, width or document revision is listed.

Interpretation: Physical category is known; compatibility and warranty are unknown. A family page may contain several products with different uses.

Do not infer: The most common product is the selected product, or the distributor will supply the same revision used in the drawing.

Safest next step: Builder requests a written submittal with exact SKUs or model names, dimensions, manuals, safety data sheets where relevant, current warranty and availability. Architect or engineer checks the substitution against the design. Homeowner holds the affected order.

Next decision: Accept the named item, accept a documented alternate, or redesign the interface.

Failure branch: the WRB is continuous on the elevation but stops at openings

Observe: The elevation looks wrapped, but window heads, sills, doors, utility penetrations, roof steps or base transitions are absent from the detail.

Interpretation: The field layer may be present while the drainage path is discontinuous.

Do not infer: Water will find its way out, or cladding will hide the gap without consequence.

Safest next step: Mark every opening and transition on the elevation. Use the DOE drainage-plane guidance as a completeness prompt, then obtain the project-specific details from the design lead and product manuals. Photograph the sequence before cover.

Next decision: Issue a coordinated detail and assign sill, jamb, head and transition work to named trades.

Failure branch: a sealant is called “compatible” without a product name

Observe: The scope says “use compatible caulk” or “standard sealant.”

Interpretation: Compatibility has not been tested against the actual membrane, flashing, insulation facer, substrate and environmental condition.

Do not infer: All polyurethane, silicone, acrylic or construction adhesives are interchangeable.

Safest next step: Record the exact sealant, primer and tape. Check the product-specific guidance and request a written manufacturer response for an unlisted combination. Check cure temperature, substrate cleanliness and movement conditions.

Next decision: Use a named approved accessory, revise the detail or document a qualified alternate.

Failure branch: the wall fits in section but the cladding has no load path

Observe: The section shows thick insulation and furring, but the order contains no attachment schedule, fastener design, stud layout or backing.

Interpretation: The thermal layer is selected before the cladding support has been designed.

Do not infer: Longer screws automatically provide adequate support, or insulation is structural simply because it is rigid.

Safest next step: Send the section, insulation thickness, cladding weight, stud spacing, wind and seismic design data, opening geometry and proposed furring to the architect or engineer and the attachment manufacturer. Use ROCKWOOL’s Board Insulation Attachment Guide to identify the variables, not to self-select a final schedule.

Next decision: Approve an engineered attachment path, change the insulation or cladding, or hold the package.

Failure branch: a code or ESR report is used as a blanket approval

Observe: A submittal includes an evaluation report, and the team says the wall is approved.

Interpretation: Evidence exists for a named product or condition, but its scope may not include the selected product, code edition, cladding, substrate or complete assembly.

Do not infer: The report replaces local review or covers neighboring products.

Safest next step: Highlight the report’s evaluation subject, code editions, properties and conditions. Confirm with the responsible design professional and the building official in the project’s actual city or county whether the proposed use follows an accepted path.

Next decision: File the report as supporting evidence, obtain an alternate approval, or redesign.

Failure branch: the interior layer is added late as “vapor barrier”

Observe: A late material list adds polyethylene, foil-faced board or another low-perm layer after the exterior wall is already selected.

Interpretation: The air and vapor strategy may be changing without a climate and drying review.

Do not infer: More vapor resistance always means a safer wall.

Safest next step: Reopen the control-layer row. Give the design professional the climate, wall layers, insulation ratio, interior finish, mechanical conditioning and penetrations. Ask for a written decision about the intended air barrier, vapor retarder and drying direction.

Next decision: Keep, relocate, change or omit the layer under the approved design.

Failure branch: trades own disconnected pieces of the same drainage path

Observe: The roofer installs step flashing, the siding trade installs WRB, and the window installer flashes openings, but no one owns the lap between them.

Interpretation: Each piece may be correct alone while the handoff is wrong.

Do not infer: The last trade on site will repair the interface.

Safest next step: The builder calls a pre-install coordination meeting with the marked-up section. Assign upper-over-lower laps, temporary protection, inspection timing and repair authority.

Next decision: Sign the joint handoff only after the assembled path is visible in photos or an inspection record.

Failure branch: the package relies on a voluntary checklist as code

Observe: Someone cites EPA Indoor airPLUS as if it were the city’s building code.

Interpretation: A program requirement and a local legal requirement have been conflated.

Do not infer: Certification requirements automatically apply to a non-certified home, or satisfying them guarantees permit approval.

Safest next step: Label the checklist “program evidence” and separately record the state, county or city code path. Use the EPA list as a quality-control prompt where useful.

Next decision: Confirm the program scope, then obtain local approval through the project’s design and permit process.

8. Close the gate and hand over a buildable package #

Release the envelope package only when the register, drawings, submittals, purchase order, inspection plan and open-risk log tell the same story; otherwise release only unaffected materials and keep the affected interface on hold.

The final owner review

Before signing an order, the homeowner should be able to answer these questions in plain language:

  • What exact material is being bought, in what unit and quantity, and which revision was reviewed?
  • What is each product’s job: structure, water control, air control, vapor control, thermal control, drainage, support, finish or protection?
  • What touches it on each side, and is the contact documented or merely assumed?
  • What is the substrate at every interface, including around openings and transitions?
  • Which accessory, tape, sealant, fastener, flashing, furring or trim is required?
  • What must happen first, what must be inspected, and what can cover the work?
  • Who owns each action: homeowner, architect, engineer, builder, trade, manufacturer or building official?
  • What exact evidence will prove completion?
  • What does the warranty cover, and what does it not cover?
  • What local rule or permit condition still needs confirmation from the project’s actual authority?
  • If the material changes, which rows and drawings reopen automatically?
  • What is the next decision after this row is accepted?

If an answer is “the builder knows,” ask for it in the register or approved drawing. The purpose is not distrust; it is to make the handoff survive a person change, a delayed shipment or a substitution.

Release checklist

Use this checklist as a decision record, not as an official inspection or code form:

  • Project state, county and city or town are recorded, with the responsible building authority identified.
  • Adopted code edition, amendments and permit conditions are assigned to the design or permit lead.
  • Climate, wind-driven-rain exposure and other design conditions relevant to the enclosure are recorded by the design professional.
  • Coordinated wall sections show structure, sheathing, WRB, flashing, insulation, cavity, cladding, interior control layers, openings and transitions.
  • Every layer has an exact product, thickness or dimension, revision, supplier and storage condition.
  • Every interface has named adjacent materials, substrate, accessory and installation sequence.
  • WRB continuity is traced at bases, tops, corners, openings, roof-to-wall joints and penetrations.
  • Masonry, stucco or other non-structural veneer includes its bond-break or drainage-plane decision where applicable.
  • Exterior insulation and cladding support have a documented load path and professional review.
  • Fastener diameter, length, spacing, embedment, washer, furring and corrosion conditions are not guessed from a product photograph.
  • Air-barrier and vapor-retarder roles are separately identified and climate-reviewed.
  • Temporary exposure, storage and protection limits are scheduled and assigned.
  • Warranty terms are tied to the exact product and accessory set; mixed-brand gaps are explicit.
  • Each trade has a pre-cover inspection record and a handoff to the next trade.
  • Substitutions use a side-by-side comparison and reopen affected rows.
  • Open risks have an owner, due point, required evidence and next decision.
  • The purchase order excludes any unresolved item whose change could alter dimensions, performance, attachment, code path or warranty.

The handoff packet

Give the builder and design lead one controlled packet containing the approved wall sections, register, product submittals, product labels or links, warranty documents, compatibility responses, attachment design, opening details, transition details, storage plan, inspection checklist, change log and open-risk list. Keep the reviewed revision date on every document.

The homeowner should retain a copy and ask how it will be updated. A packet that is accurate before ordering can become false after a substitution, a revised window schedule or a field repair. Add a revision row rather than editing history away. The next decision after release is not “forget the wall”; it is whether the installed work matches the released package before it is covered. For the records, maintenance responsibilities and owner-facing closeout that follow, use handover and ownership planning once the installed package is verified.

What to photograph and what to ask a professional

Photographs are useful when they identify location and scale. Take wide and close views of each opening, corner, base, top, penetration, transition, seam, flashing lap, furring line and cladding joint before concealment. Include a date, wall elevation, story and nearby reference. Photograph product labels and damaged deliveries. Do not treat a photograph as proof of concealed fastener embedment or moisture condition unless the record actually shows that fact.

Bring the following to the responsible professional:

  • the exact product submittal and current installation guide;
  • the coordinated wall section and opening schedule;
  • the proposed cladding weight and attachment concept;
  • exterior insulation thickness and facer;
  • stud spacing, sheathing and backing information;
  • project address and state, county and city or town;
  • permit and adopted-code information available from the local authority;
  • climate and exposure assumptions used in design;
  • all proposed tapes, sealants, flashings, fasteners and furring;
  • the construction schedule and expected temporary exposure;
  • any manufacturer email or technical response; and
  • the specific row that remains amber or red.

Ask a focused question: “For this exact product revision on this substrate, next to these named materials, installed in this sequence and exposed for this period, what evidence supports the use, what conditions apply, who approves it, and what record should we retain?” That question is more actionable than “Are these products compatible?”

Final decision tree

If every affected row is green, the design lead and builder can authorize the corresponding purchase under the contract’s approval process. If only unaffected rows are green, release those materials and identify the held rows on the purchase order. If a red row affects the wall’s control layers, structure, fire performance, attachment, opening drainage, local code or warranty, do not order the dependent package. Route the question to the named professional or authority, attach the evidence and update the register when the answer arrives.

The final gate is therefore simple but demanding:

Order the coordinated package only when the register shows exact materials, documented interfaces, a buildable sequence, named responsibility, verifiable completion evidence and known warranty and jurisdiction limits. Otherwise, order nothing that commits the unresolved decision.

That gate turns a scattered set of product pages into a homeowner-readable project record. It does not make the homeowner an engineer or inspector. It gives the people who are authorized to decide the information they need early enough to prevent an incompatible accessory, unsupported cladding, unplanned cavity, broken drainage path or warranty gap from becoming a concealed construction problem.

Method and limitations of the source-comparison worksheet

Method: The worksheet separates physical fit, documented compatibility, code or evaluation evidence, verification evidence and warranty coverage. It maps each selected layer and interface to its exact product revision, substrate, adjacent materials, accessory, sequence, exposure limit, responsible person, inspection record, warranty condition, unresolved risk and next handoff. The illustrative example uses stated inputs, units and formulas, then changes exterior insulation thickness and cladding weight to show which decisions reopen. Source inputs include DOE enclosure guidance, DOE air/vapor guidance, EPA Indoor airPLUS Version 2, APA moisture guidance, the current official ICC-ES ESR-1993 report, the ICC-ES report-directory status note, and the named manufacturer documents linked throughout. The declared method is: Separate physical fit, documented product compatibility, code or evaluation evidence, installation sequence and warranty coverage; populate one row per layer or interface from the selected revision-controlled documents, then test the register against an illustrative two-wall package and a thickness-and-cladding-weight sensitivity.

Limitations: The example is illustrative and modeled. It contains no site measurements, laboratory tests, interviews, field inspection, engineering calculation, local code determination or manufacturer approval. The cited product values and conditions apply only to the named source and scope. The project’s actual state, county or city rules, permit conditions, design documents, professional judgment, manufacturer instructions and warranties control. Remote review cannot approve structural, fire, vapor-control or hygrothermal performance. A professional must resolve those matters before release when they are relevant. The declared limitations are: The example is modeled and illustrative, not a tested assembly or design approval. Manufacturer instructions, the adopted code and amendments in the project's actual state, county or city, and a licensed design professional control; the register cannot remotely approve structural, fire, vapor-control or hygrothermal performance.

Your next decision

Make your next decision clearer.

Search another question or explore more posts about your home.

Cite this guide

Brictale. “How to Prepare a New-Home Building-Envelope Materials Compatibility Register Before Ordering.” Published 2026-10-06; updated 2026-10-06.

https://brictale.com/build/materials/prepare-new-home-building-envelope-materials-compatibility-register-before-order · Read the Markdown version

Original contribution: Envelope compatibility register and pre-order release gate. A reproducible worksheet maps each envelope layer and interface to product identity, source evidence, sequence, responsibility, verification, warranty conditions, unresolved risk and the next handoff.

Sources and scope

Evidence behind this page

Updated 2026-10-0614 attached claimsUnited States; local conditions vary
  1. A continuous drainage plane or WRB belongs behind exterior cladding, and it must be integrated with flashing at openings, wall bases, tops and penetrations so water can drain outward.

    Building Enclosure Science Intro: Drainage Plane Behind Exterior Wall Cladding

    U.S. Department of Energy Building Science Education guidance; general wall-enclosure concept, not a project-specific code approval or product endorsement.

    Accessed · Link to this claim
  2. An air barrier controls air-transported moisture while a vapor retarder reduces vapor diffusion; whether, where and how a vapor retarder is used depends on climate and construction, and continuity and sealing matter.

    Building Enclosure: Air Barriers vs Vapor Barriers Continuous Sealed WRB on Walls

    U.S. Department of Energy Building Science Education guidance; conceptual moisture-control guidance across U.S. climates, not a substitute for the adopted code or hygrothermal design.

    Accessed · Link to this claim
  3. EPA Indoor airPLUS Version 2 lists continuous WRB behind cladding, a bond-break drainage plane for non-structural masonry, flashing or drainage at horizontal interruptions and wall bottoms, weeps or a weep screed where applicable, and fully flashed windows and doors as water-managed wall checks.

    Indoor airPLUS Verification Requirements Version 2

    EPA Indoor airPLUS Version 2, July 2024; program verification requirements, not a universal U.S. building code and not applicable unless the home participates in that program.

    Accessed · Link to this claim
  4. APA identifies missing or improper flashing, WRB installation and wall intersections or penetrations as common contributors to wall water damage; it describes WRB lapping, sealing and flashing integration as critical and notes that rainscreens can add protection in wind-driven-rain areas.

    Moisture Mitigation: Designing and Building for Long-Term Performance

    APA engineered-wood moisture mitigation guidance; general design and construction guidance, with site, climate and code decisions still project-specific.

    Accessed · Link to this claim
  5. The current official ICC-ES ESR-1993 PDF identifies DuPont Tyvek ThermaWrap LE (Style 3583M), evaluated properties, code editions and conditions, and states that the report is not an endorsement or a finding about unaddressed attributes; its cover is reissued August 2024 and marked 'Subject to renewal August 2026'.

    ICC-ES Evaluation Report ESR-1993: DuPont Tyvek ThermaWrap LE

    Official ICC-ES ESR-1993 PDF at the current direct report-directory path, checked September 29, 2026. It covers the named Tyvek ThermaWrap LE product and listed conditions, not every DuPont WRB or every wall assembly; the separate ICC-ES report-directory status record explains how the past re-examination date is treated.

    Accessed · Link to this claim
  6. ICC-ES states in its official report directory that downloadable evaluation reports remain valid even when a re-examination date has passed, because some are undergoing re-examination or are legacy reports whose period has been extended without changing the displayed date.

    ICC-ES Report Directory

    Official ICC-ES report directory status note checked September 29, 2026; it explains the directory's treatment of passed re-examination dates and does not decide whether a local building authority accepts a report or whether the listed product fits a project-specific assembly.

    Accessed · Link to this claim
  7. DuPont's revised March 12, 2025 typical wall drawing shows Tyvek WRB over Styrofoam XPS and OSB in a residential wood-frame wall, calls for taped joints, gives 6–12 inch vertical seam overlap and a minimum 6 inch shingle-style horizontal lap, and sends vapor-retarder and sealant questions to applicable code and product guidance.

    Typical Wall Assembly: Residential Wood Frame Structure with Tyvek WRB over Styrofoam XPS Insulation

    DuPont drawing SF-OP-1201B-MA-ISO, revision date March 12, 2025; typical, not-to-scale, cladding-neutral assembly and not a project-specific design.

    Accessed · Link to this claim
  8. DuPont lists Weathermate Plus Housewrap as having a 5 perm minimum water-vapor transmission rating and says it can remain uncovered for up to 120 days, while directing users to review instructions and contact a product specialist before writing specifications.

    DuPont Weathermate Plus Housewrap Product Page

    DuPont product page for Weathermate Plus Housewrap; listed product properties and stated exposure guidance, not a universal limit for other WRBs or a permission to delay cladding.

    Accessed · Link to this claim
  9. DuPont's U.S. warranty overview distinguishes product-only Weathermate Plus coverage from Tyvek wrap systems paired with specified DuPont flashing and, for some options, DuPont continuous insulation; the listed terms and covered properties differ by system.

    United States Residential Warranties

    DuPont U.S. residential warranty overview; summary table only, with product-specific warranty documents, exclusions and installation conditions controlling.

    Accessed · Link to this claim
  10. Benjamin Obdyke states HydroCorner is compatible with most caulks, sealants and straight-flashing tapes, and says a mechanical fastener is sufficient to hold it before sill flashing; this is a product-specific statement, not approval of every sealant or flashing combination.

    Benjamin Obdyke FAQs: HydroCorner

    Benjamin Obdyke FAQ for its HydroCorner product; 'most' is not universal compatibility and the selected product instructions remain controlling.

    Accessed · Link to this claim
  11. James Hardie says no exterior cladding prevents 100% of water intrusion and presents its weather-barrier suite as separate housewrap, flashing, flex flashing and seam-tape products, with availability potentially limited by location.

    Hardie Weather Barrier Products

    James Hardie product-category page; manufacturer description of its named products, not a performance guarantee for a mixed-brand wall.

    Accessed · Link to this claim
  12. James Hardie's lap-siding guidance recommends 6-inch-wide flashing behind siding butt joints with a 1-inch overlap of the course below, while warning that some local building codes may require a different flashing size and that the material must not react with cement products.

    How to Install Lap Siding: Tips for Installing James Hardie Lap Siding

    James Hardie lap-siding installation guidance; recommendation for its siding context and an explicit reminder to check the local building code.

    Accessed · Link to this claim
  13. ROCKWOOL's Comfortboard 80 residential guide recommends permanent mechanical attachment, mechanical fasteners with minimum 2-inch-diameter washers, and at least five attachments per board when only mechanical fasteners or impaling pins support the board; cladding attachment systems may require different fastening.

    ROCKWOOL Comfortboard 80 Residential Installation Guide

    ROCKWOOL Comfortboard 80 residential installation guide; baseline product guidance, not structural attachment design for a particular cladding or wind exposure.

    Accessed · Link to this claim
  14. ROCKWOOL's board-attachment guidance organizes cladding attachment around insulation thickness, cladding weight, stud spacing, fastener size and strapping, and says long screws must penetrate framing members and project-specific cladding loads affect specification.

    ROCKWOOL Board Insulation Attachment Guide

    Official ROCKWOOL Board Insulation Attachment Guide checked September 29, 2026; its example tables and recommendations are illustrative attachment guidance, not a substitute for engineering, adopted code or manufacturer review of the selected assembly.
